A full bathroom remodel takes 4 to 8 weeks of construction for most Tampa Bay homes, measured from demolition day to final walkthrough. How soon construction starts is a separate question, and it mostly depends on you: demolition is scheduled once your design is signed off, every material selection is final and delivered, and the county issues the permit. Homeowners who make decisions quickly start quickly. Smaller scopes move faster: a tub to shower conversion often finishes in 2 to 3 weeks, while a large primary bathroom with layout changes can run 8 to 10 weeks. This guide walks through the entire timeline week by week, and instead of describing a hypothetical project, it follows a real one: a guest bathroom we remodeled in Safety Harbor, photographed at every phase from the day materials arrived to the finished room.
Written with Terry, accredited designer at CMK Construction. Reviewed by CMK Construction Inc, Florida State Certified General Contractor CGC 1516665.

Bathroom Remodel Timeline at a Glance
Construction time depends almost entirely on scope. Here is what we see across our Tampa Bay and Sarasota projects, measured from demolition to final walkthrough.
| Project Scope | Construction Time, Demolition to Walkthrough |
|---|---|
| Tub to shower conversion | 2 to 3 weeks |
| Guest or hall bathroom, same layout | 4 to 6 weeks |
| Full primary bathroom, same layout | 5 to 7 weeks |
| Primary bathroom with layout changes | 6 to 8 weeks |
| Bathroom addition or expansion | 8 to 12 weeks |

Wondering what each scope costs alongside these timelines? As a general guide from our own published pricing, guest bathroom remodels start around $15,000, full primary bathrooms run $30,000 or more, and mid range projects with layout changes typically land between $25,000 and $50,000. The full breakdown lives in our bathroom remodel cost guide.
The Safety Harbor project pictured throughout this guide sits in the second row of that table: a guest bathroom rebuilt in its existing layout, with the tub replaced, the walls opened to the studs, and everything from waterproofing to glass done new. Two things separate projects that hit these ranges from projects that drag on for months: every material is selected and in hand before demolition starts, and the plumbing and electrical trades are coordinated instead of subcontracted to whoever is available. Both come up again below, because both are visible in the photos.
The Project We Followed: A Safety Harbor Guest Bathroom

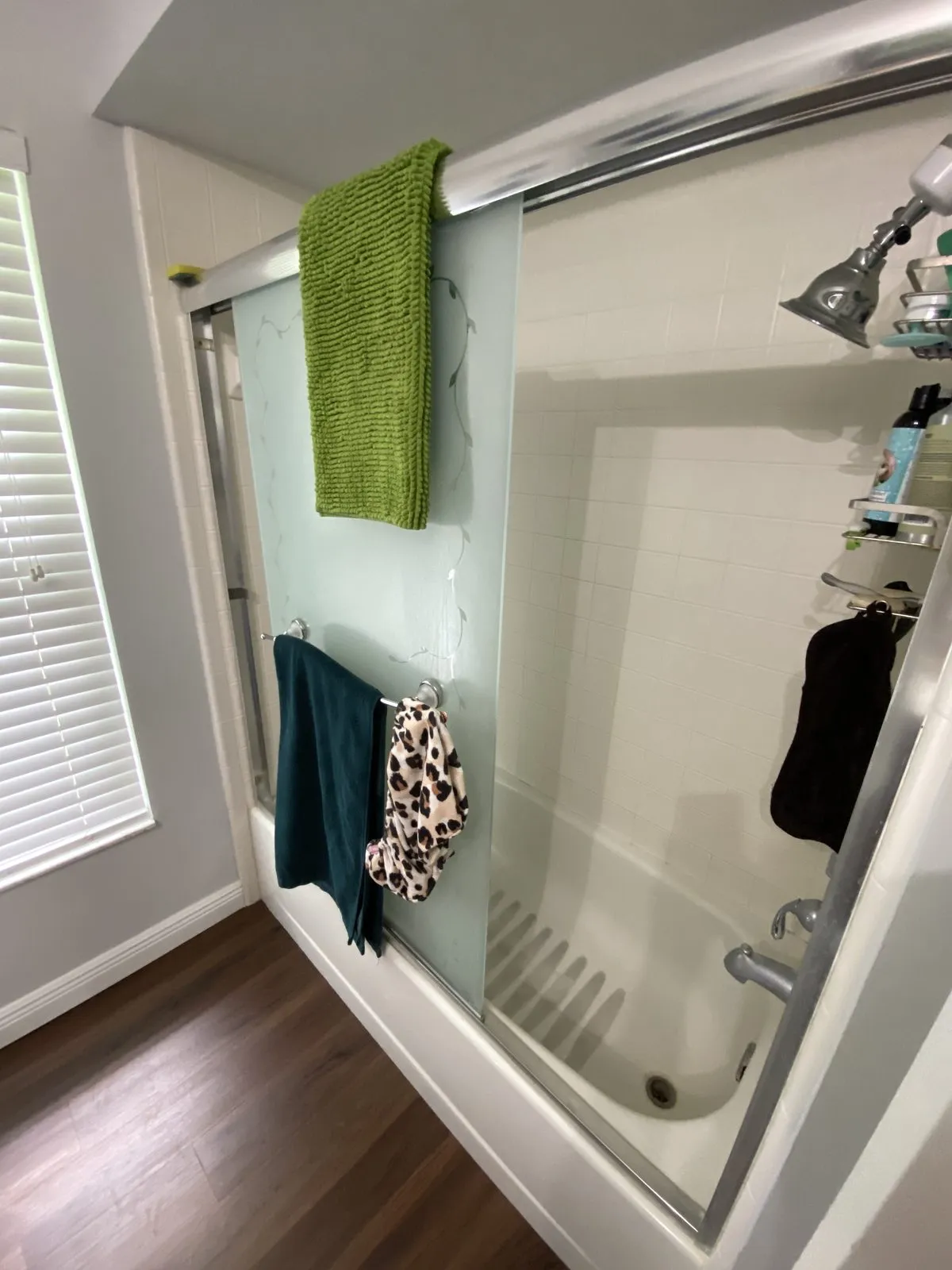

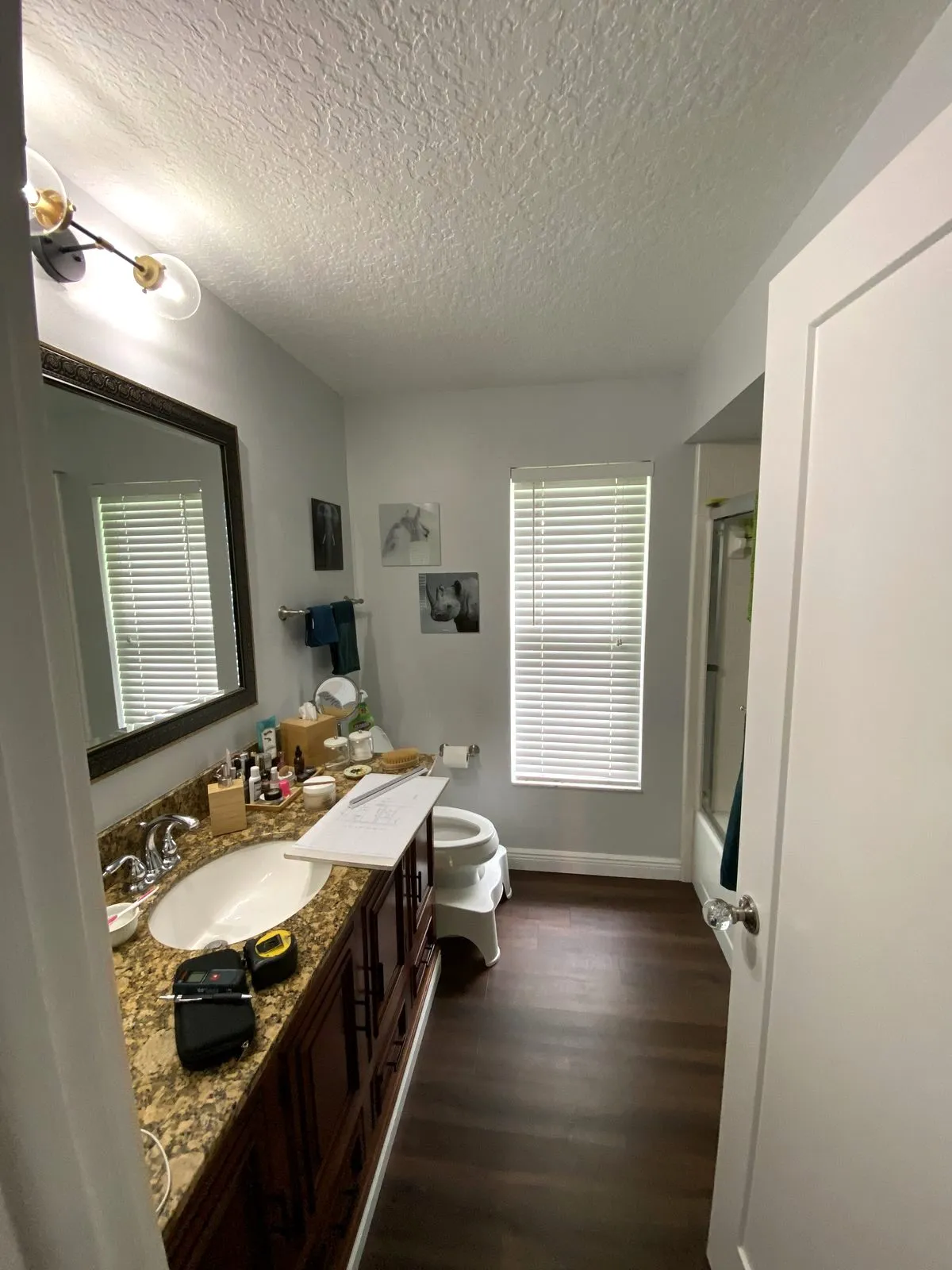

This is where the project started. A functional but dated guest bathroom in Safety Harbor: original tub, aging tile surround, and finishes that had reached the end of their life. The homeowners wanted the same footprint rebuilt properly, which is the most common bathroom remodel we do and the best baseline for understanding the timeline.

What Happens Before Construction Starts
The period before demolition determines whether the construction schedule holds, and unlike construction, there is no fixed length for it, because the two biggest inputs are outside the contractor’s control: how quickly you finalize your design and selections, and how quickly the county issues the permit. Homeowners often ask why we do not start tearing out tile the week after signing, and the answer is that starting before selections are final and materials arrive is the single most common cause of stalled bathroom remodels. Here is what happens before demo day on a CMK project, and who controls each piece.
Design and Material Selection: The Part You Control
After you sign, you sit down with your accredited designer at our Design Studio and select every material in your project in one coordinated visit: tile, vanity, countertop, fixtures, shower glass, lighting, and hardware. Seeing the actual tile next to the actual countertop slab prevents the mid project change orders that add weeks to a schedule. Selections that would take a homeowner a month of weekend showroom trips get finalized in a single session, and every choice is documented in the project scope before anything is ordered. This step moves exactly as fast as your decisions do: homeowners who come in knowing their style and sign off decisively can wrap it in a single visit, while revisiting choices adds time before anything can be ordered. It is the one part of the whole project schedule that is fully in your hands.
Material Ordering and Staging: Scheduled Off Your Sign Off

Tubs, tile, glass, and fixtures ship on different schedules, and any one of them arriving late can idle a job site. We order everything up front, and demolition is not scheduled until every material for the project is in hand. The photo below is what that policy looks like in practice: the Safety Harbor homeowner’s garage on delivery day, with the tile boxes, Schluter waterproofing kit, thinset, and trim stacked and inventoried before a single hammer swung. When a project is staged like this, the crew never stops to wait on a shipment, which is the single biggest reason our bathrooms finish inside the ranges in the table above.

Permitting: On the County’s Clock, Runs in Parallel
A full bathroom remodel in Florida requires permits whenever plumbing or electrical work is involved, which is nearly always. Permit turnaround is on the county’s clock, not yours or ours: Hillsborough, Pinellas, Pasco, Sarasota, and Manatee each run their own review queues, and timing shifts with how busy each office is in a given season. As a state certified general contractor, we submit for permits as soon as your design is signed off, and because the county review overlaps the material ordering window, it usually costs the schedule nothing. Unpermitted bathroom work is a real problem in the Tampa Bay resale market, and inspectors sign off on our work at every required stage.
The Week by Week Construction Timeline

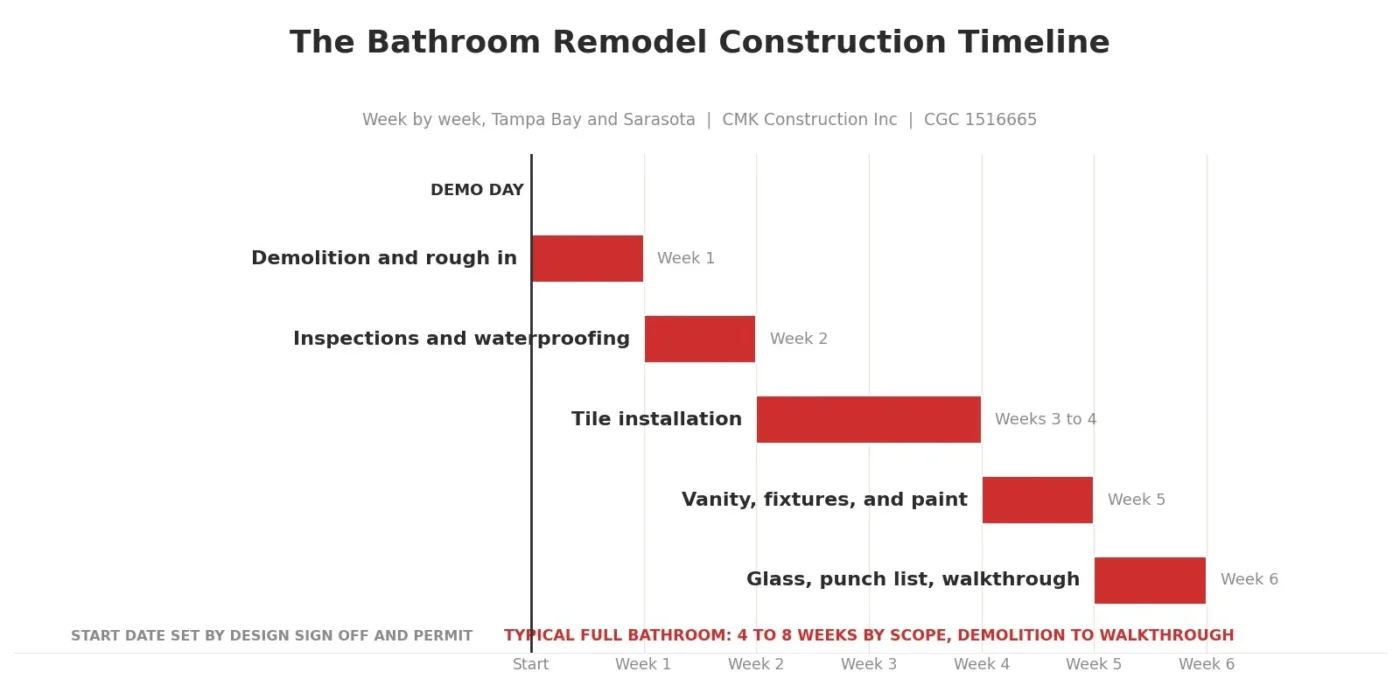

Here is how the 4 to 8 construction weeks actually break down, illustrated by the Safety Harbor project at each phase. Smaller scopes compress these phases and larger ones stretch them, but the sequence never changes, because each phase physically depends on the one before it.
Week 1: Protection, Demolition, and Rough In

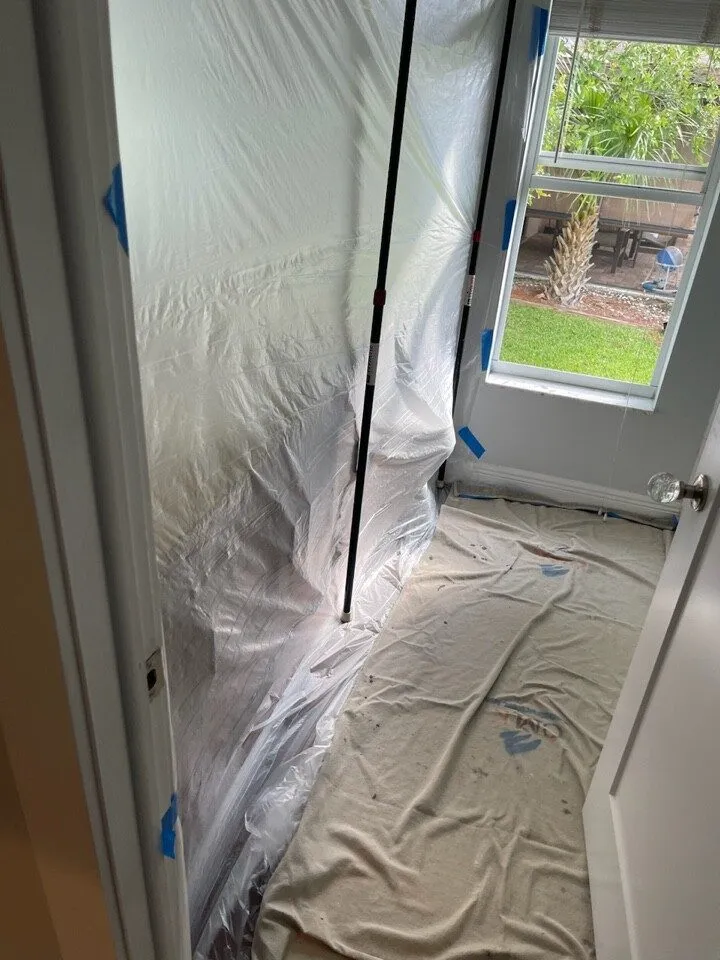

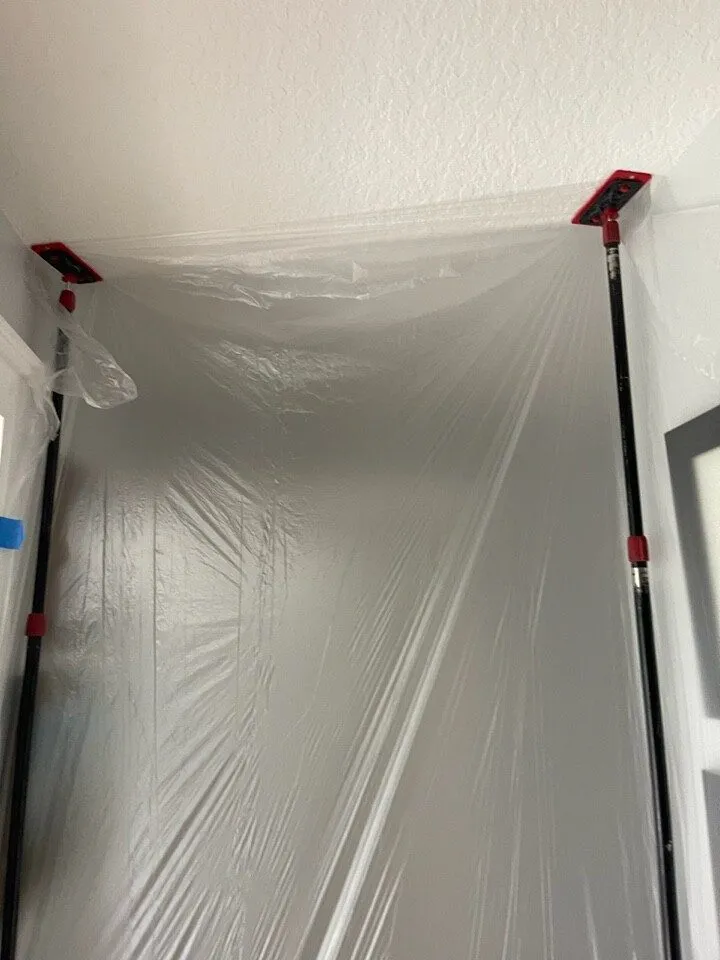

Demolition starts before the first hammer swings, with protection. Floors get covered along the entire path from the front door to the bathroom, and the work zone is sealed behind plastic dust containment so remodeling dust stays out of the rest of the house. Both steps are visible below from demo day in Safety Harbor, and they are worth asking any contractor about, because a crew that skips protection on day one tells you how the next six weeks will go.

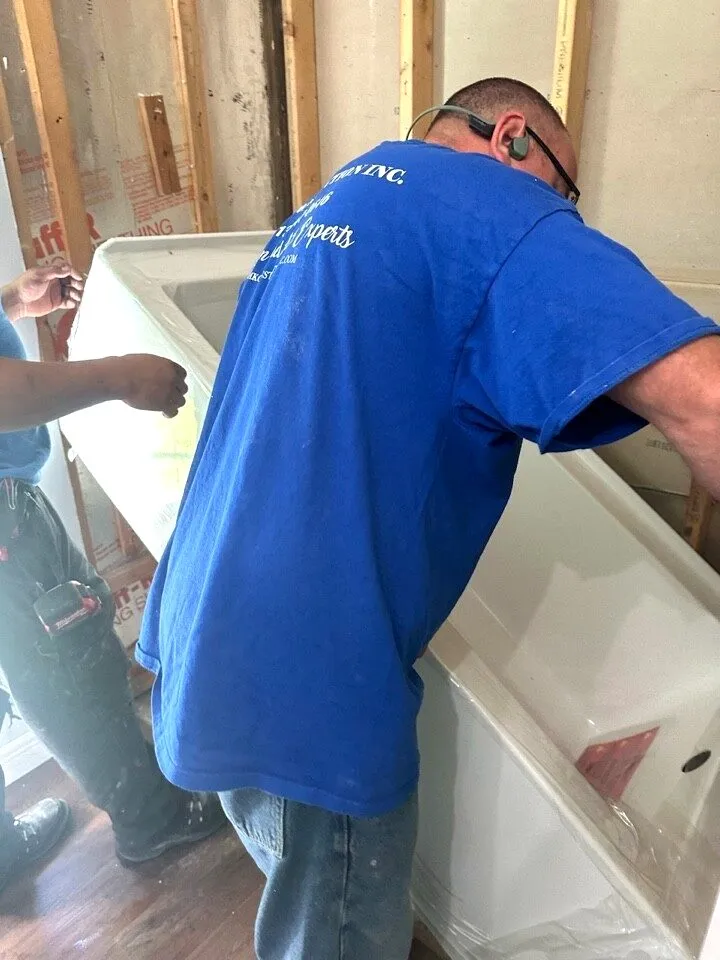

The bathroom itself comes down to the studs in 1 to 2 days. What follows matters more: the rough in, where plumbing is replaced or rerouted and electrical is run for new lighting, outlets, and exhaust fans. This is where hidden conditions surface. In older Safety Harbor, South Tampa, St. Petersburg, and Dunedin homes we regularly open walls to find cast iron drains, galvanized supply lines, or previous unpermitted work that has to be corrected before anything new goes in. Because our plumbers are in house and our electrical is coordinated through one licensed process, those discoveries get handled the same week instead of waiting on an outside subcontractor’s calendar. In Safety Harbor, our plumbing team set the new tub and completed the rough plumbing in the same week the room was gutted, which is what a coordinated schedule looks like.

Week 2: Inspections and Waterproofing

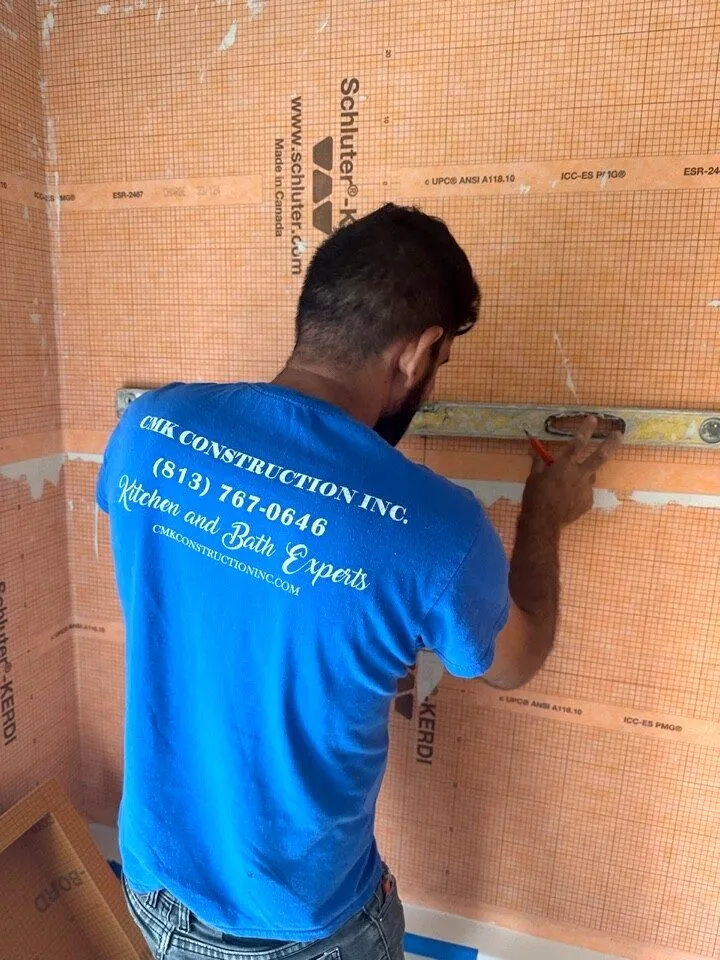

The county inspects the rough plumbing and electrical before walls close. Once inspections pass, backer board goes up and the wet area is waterproofed. We install Schluter waterproofing systems on every bathroom we build, and the orange membrane wrapping the Safety Harbor tub surround below is what that looks like before tile: a continuous waterproof layer across every wall, seam, and corner that will ever see water. It takes slightly longer than the paint on membranes some contractors use, but it is the reason our showers are not the source of wall rot ten years from now. Florida humidity punishes shortcuts in this phase more than any other, and it is the one week of the schedule we will never compress.

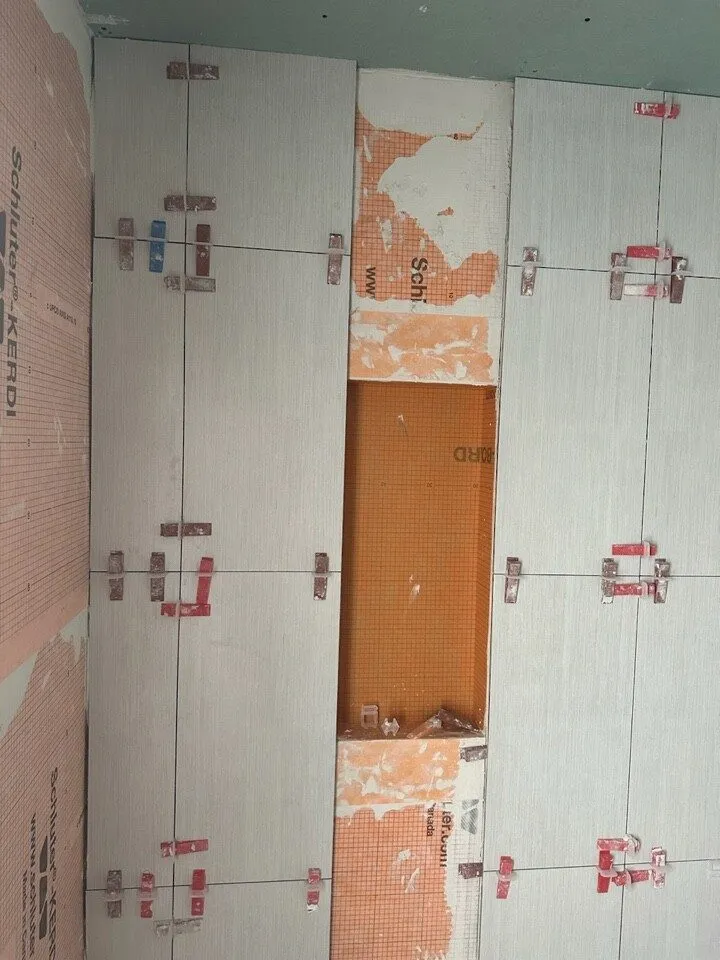

Weeks 3 to 4: Tile
Tile is the longest single phase in most bathroom remodels, and it is also the phase homeowners watch most closely because it defines the finished look. Floor tile, shower walls, niches, and accent work each take setting and curing time that cannot be rushed. In Safety Harbor, the crew set large format tile with a leveling system on every wall, which is how the finished surround reads as clean, continuous lines with tight lippage free joints. A standard tile package runs about a week; large format tile, intricate patterns, or floor to ceiling installations run closer to two. If you are weighing tile choices before your project, our guide to walk in shower cost in Tampa Bay breaks down how tile selections affect both budget and schedule.

Week 5: Vanity, Countertop, and Fixtures
With tile set, the room gets built back: vanity installation, countertop, sinks, faucets, toilet, lighting, exhaust fan, and paint. Because every one of these items has been staged since before demolition, this phase is pure assembly rather than a scavenger hunt. Sequencing still matters here: paint goes on before fixtures so nothing gets cut in around new hardware, plumbing trim is set by the same in house team that did the rough in, and electrical trim runs through the same single licensed process, so the room comes together in days rather than a rotation of separate crews. It is also the fastest visible progress of the whole project, and the week the space starts looking like the design rendering you approved.
Week 6: Glass, Punch List, and Final Walkthrough

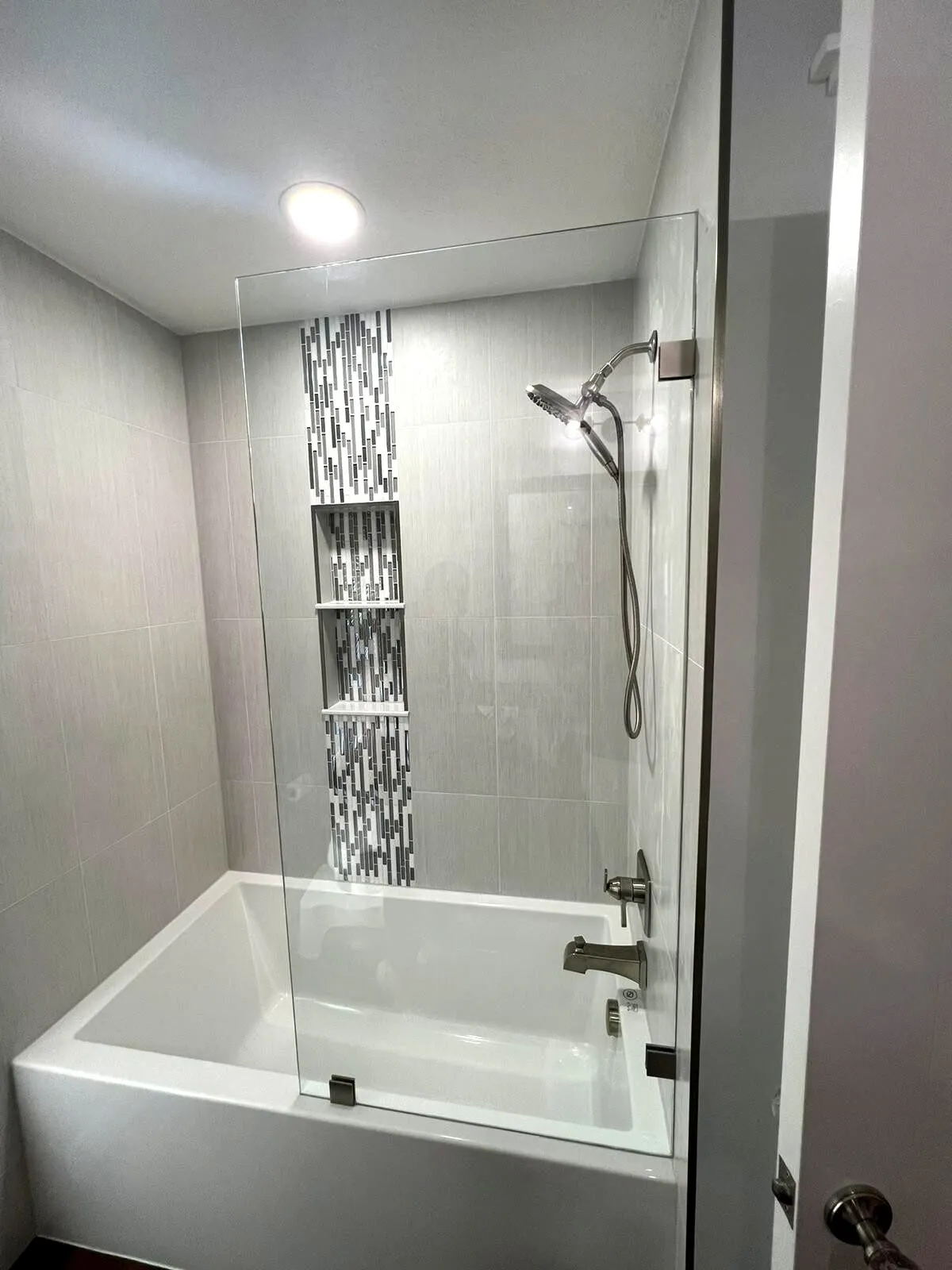

Frameless shower glass is measured after tile is complete because it is templated to the finished opening, then fabricated and installed about a week later. The fixed glass panel on the Safety Harbor tub in the photo at the top of this guide went in during this final week, along with the fixture trim and hardware. While glass is in fabrication, your project manager works the punch list: caulk lines, hardware adjustments, paint touch ups, and a final clean. The project closes with a walkthrough where you and your project manager confirm every item together, room by room, before anyone considers the job done. Final county inspection sign off follows, which is your independent confirmation that every trade behind those walls was done to code. From that day the household is fully back to normal, and your remodel is covered by our one year Peace of Mind Warranty.
Want a detailed cost picture to go with this schedule? Our full breakdown of bathroom remodel cost in Tampa covers what each scope level runs in 2026.
Want a written timeline for your specific bathroom? Schedule a free in home consultation and we will walk your space, discuss scope, and give you a real schedule, not a guess. Call (813) 379-2116 or book online.
7 Things That Delay a Bathroom Remodel
When a bathroom remodel blows past its schedule, the cause is almost always one of these seven. Knowing them ahead of time is the best protection you have, whoever you hire.
- Starting demolition before materials arrive. The most common mistake in the industry. A gutted bathroom waiting on a backordered vanity is a bathroom that sits unusable for weeks. The Safety Harbor garage photo above is the alternative: everything on site before demo day.
- Mid project change orders. Changing tile after the shower is waterproofed or swapping a vanity after plumbing is roughed in restarts ordering clocks and resequences trades. Finalizing every selection during design is what makes the construction schedule hold.
- Hidden conditions behind the walls. Cast iron drains, water damage, mold, and previous unpermitted work are common in Tampa Bay homes built before the 1990s. They must be corrected, and a contractor with in house plumbing corrects them in days rather than weeks.
- Subcontractor scheduling gaps. When plumbing, electrical, tile, and glass are four separate companies, every handoff is a chance for the job to sit idle. Coordinated trades under one contractor keep the sequence tight.
- Permit and inspection queues. County review times fluctuate. A contractor who pulls permits weekly in every Tampa Bay county knows the current turnaround and builds it into your schedule instead of being surprised by it.
- Custom and special order items. Custom glass, imported tile, and special order vanities have long lead times. None of them need to delay a project if they are ordered at signing rather than mid build.
- Homeowner decision delays. Grout color, hardware finish, paint sheen: small decisions stall job sites when they are left open, and slow design sign off is the most common reason two identical projects start weeks apart. Our design process closes every decision before demolition so nothing waits on a choice.
How Timelines Differ by Project Type
Tub to Shower Conversions Are the Fastest Full Remodel
A tub to shower conversion keeps the plumbing in roughly the same location, which removes most of the rough in work and compresses the schedule to 2 to 3 weeks of construction. It is the fastest way to fully transform a bathroom, which is a big part of why it has become one of our most requested projects. Our complete guide to tub to shower conversions in Tampa covers costs, layouts, and what to expect.
Layout Changes Add 1 to 2 Weeks
The Safety Harbor project kept its layout, which is one reason it fit the 4 to 6 week window. Moving a toilet, relocating a shower, or converting a tub deck into a freestanding tub with a separate shower all require rerouting drains and supply lines, additional inspections, and sometimes slab work. Budget an extra 1 to 2 weeks whenever fixtures move. The payoff is a bathroom that finally functions the way your family lives, and in our experience homeowners who change a bad layout never regret the extra time.
Condos Run on a Different Clock
Condo bathroom remodels along the water in St. Petersburg, Clearwater, and Sarasota are their own category, and both halves of the timeline stretch. Before work starts, association approvals, insurance certificates, and architectural review add lead time on the building’s schedule, not anyone else’s. Then construction itself runs longer than the same scope in a single family home, because every day carries condo logistics: materials and debris move through a reserved elevator instead of a driveway, work hours are restricted by HOA rules, common areas have to be protected on every trip, and loading dock access is shared. A guest bathroom that would take 4 to 6 weeks in a house should be planned with extra construction time in a condo. We remodel condo bathrooms regularly, handle the association paperwork, and build both the approvals and the building logistics into the written schedule from day one.
How to Keep Your Bathroom Remodel on Schedule
Most schedule protection happens before construction starts, and a surprising amount of it is in the homeowner’s control. Make every selection during the design phase and resist changes once ordering begins. Ask any contractor you interview two questions: whether materials are ordered and received before demolition, and whether plumbing and electrical are performed in house or subcontracted out. Clear the bathroom and the path to it before demo day, and decide early where the household will shower during construction. Our guide on preparing your Tampa home for a remodel covers the full prep checklist.
And if a kitchen is also on your list, timelines for the two rooms work very differently. Our companion guide covers how long a kitchen remodel takes in Tampa week by week.
Why CMK Bathroom Remodels Stay on Schedule
Everything in this guide reflects how we have built bathrooms across Tampa Bay since 2004, and every photo above came from one real project running that process. Materials are selected in one design session and staged before demolition. Plumbing is self performed by our own state certified plumbing team under CFC 1430533, and electrical is coordinated through one licensed process, so trades never wait on each other. Every project gets a dedicated project manager who communicates constantly and owns the schedule from demo day to walkthrough. Permits are pulled and inspections scheduled by us as your state certified general contractor, CGC 1516665. It is the process behind 7,136+ completed projects and six consecutive Tampa Bay Times Best of the Best awards, and it is why the ranges in this guide are numbers we actually hit. You can see where a bathroom project starts on our bathroom remodeling page.
Ready to find out exactly how long your bathroom will take? Book a free in home consultation and get a written scope and schedule for your project. Call (813) 379-2116 or schedule online.
Bathroom Remodel Timeline FAQs
How long does a bathroom remodel take from start to finish?
The construction phase, from demolition to final walkthrough, runs 4 to 8 weeks for most Tampa Bay homes depending on scope, with tub to shower conversions at the short end and primary bathrooms with layout changes at the long end. The time between signing and demo day is a separate window with no fixed length, because it is driven by the two inputs a contractor does not control: how quickly you finalize your design and selections, and how quickly your county issues the permit. Homeowners who sign off on their design in the first visit and pick in stock materials start construction much sooner than homeowners who revisit selections or choose long lead custom items. What we control, we lock down: materials are ordered the moment you sign off, staged before demolition, and the permit is submitted immediately, so once the county and your selections are done, your start date is set. That staging is exactly what the Safety Harbor garage photo in this guide shows.
Can a bathroom be remodeled in 2 weeks?
A tub to shower conversion or a cosmetic refresh can be completed in about 2 to 3 weeks of construction, because the plumbing stays in place and the scope is contained to one area of the room. A full gut remodel realistically cannot be done properly in 2 weeks, and homeowners should be cautious of anyone promising it. The schedule has hard physical limits: county inspections must happen before walls close, waterproofing and tile mortar need cure time before the next phase can start, and frameless shower glass can only be measured after tile is finished and then takes about a week to fabricate. A contractor who compresses past those limits is skipping inspections, rushing waterproofing, or both, and in Florida humidity, rushed waterproofing is how a beautiful new bathroom becomes a mold problem two years later.
What takes the longest in a bathroom remodel?
Tile is the longest single construction phase in most bathroom remodels, typically running 1 to 2 weeks depending on how much of the room is tiled and how complex the pattern is. Floor tile, shower walls, niches, and accent bands each require setting time and cure time that cannot be compressed, and large format tile or floor to ceiling installations take longer than standard layouts. Outside of construction itself, the longest lead time item is usually custom shower glass or a special order vanity, which is exactly why those items should be ordered at contract signing rather than mid project. When we stage materials before demolition, those long lead times overlap with permitting instead of adding weeks to the end of your project.
Do I need a permit to remodel a bathroom in Florida?
Yes, in nearly every case. Florida requires permits whenever plumbing or electrical work is performed, which covers almost any real bathroom remodel: moving or replacing supply lines and drains, adding or relocating outlets, installing new lighting or exhaust fans, and any structural changes. Purely cosmetic work such as painting or swapping a faucet like for like generally does not require a permit. Permit turnaround varies by county across Hillsborough, Pinellas, Pasco, Sarasota, and Manatee and shifts with how busy each office is in a given season, and inspections are required at set stages before work can continue. As your state certified general contractor, CMK pulls every permit and schedules every inspection, and because permitting runs parallel to material ordering, it rarely adds time to your total schedule. Unpermitted bathroom work can create real problems at resale and with insurance claims, so it is never a corner worth cutting.
Can I use my bathroom during the remodel?
Not the one being remodeled. From demolition day until final walkthrough, that bathroom is a construction zone with no working fixtures, so plan on it being fully out of service for the entire construction window of 4 to 8 weeks. Most homes have a second bathroom that carries the household through the project, and we protect the pathway between the work area and the rest of your home so daily life stays as normal as possible, exactly as shown in the demo day photos in this guide. If your home has only one bathroom, tell us during your consultation. We sequence single bathroom projects to restore a working toilet and shower as early in the schedule as the inspection sequence allows, and we help you plan for the days when the room is genuinely unusable.
Why do older Tampa Bay homes take longer to remodel?
Homes built before the 1990s across Tampa Bay frequently hide conditions inside the walls that only become visible after demolition: cast iron drain lines that have corroded from the inside, galvanized steel supply pipes at the end of their lifespan, undersized electrical circuits, water damage from old leaks, and previous unpermitted work that has to be brought up to code. None of these are optional fixes, because closing new tile over failing pipes guarantees a much more expensive project later. The schedule impact depends on who handles the correction. When plumbing repairs require calling an outside subcontractor, a discovery can idle a job for a week or more. Because CMK’s plumbers are in house and our electrical is coordinated through one licensed process, corrections are typically handled within the same week they are found, which keeps most older home projects inside the normal 4 to 8 week construction window.
How long does a bathroom remodel take in a condo?
Longer than the same project in a single family home, on both ends of the timeline. Before construction, most associations in St. Petersburg, Clearwater, Sarasota, and along the Tampa Bay waterfront require an architectural review or remodel application, proof of contractor licensing and insurance, and elevator reservations, all approved on the association’s schedule. Then construction itself runs longer than the ranges in this guide for an equivalent scope, because condo logistics slow every single day of the job: crews and materials travel up and down a reserved elevator rather than in and out of a driveway, HOA rules restrict work hours, debris removal takes coordinated trips, and common areas must be protected and cleaned constantly. None of that is wasted time, it is what working correctly inside a shared building requires. We remodel condo bathrooms throughout the area, handle the association paperwork as part of the project, and write the building’s rules and logistics into the schedule from the start, so the timeline you approve already reflects condo reality instead of a single family assumption.
How long does a shower remodel take?
A shower remodel on its own takes 2 to 4 weeks of construction, faster than a full bathroom because the vanity, flooring, and paint scope drops away. The sequence is the same as the full timeline in this guide, just compressed: demolition of the old surround, rough plumbing for the new valve and head, county inspection, Schluter waterproofing, tile, and then glass measured off the finished opening and installed about a week later. Glass fabrication is usually the item that defines the finish date, which is why it is templated the day tile is complete. A tub to shower conversion runs the same 2 to 3 week window since the drain location typically stays put. You can see the full scope of what we build, from standard surrounds to curbless entries, on our shower remodeling page.
Does permit approval count toward the remodel timeline?
It counts toward the total project timeline but usually not toward the construction timeline, and the difference matters when you compare contractor quotes. Permit review runs on each county’s queue in Hillsborough, Pinellas, Pasco, Sarasota, and Manatee, and on a well run project that review happens during the same window as design selections and material ordering, so it adds nothing to the calendar. Where permits genuinely extend a project is when a contractor starts demolition before the permit is issued and then has to stop work, or when required inspections are failed and rescheduled mid build. When we quote 4 to 8 weeks of construction, that is demolition to walkthrough with permits already in hand, and the inspection stops are built into the week by week schedule rather than added onto the end of it.
CMK Construction Inc is a Florida State Certified General Contractor (CGC 1516665) and State Certified Plumbing Contractor (CFC 1430533) serving Hillsborough, Pinellas, Pasco, Sarasota, and Manatee counties since 2004, with 7,136+ completed projects and six consecutive Tampa Bay Times Best of the Best awards.
